Scenario 2: Product Implementation

Objective: To guide Zylker’s implementation team through their installation and demo process when a new product is installed for the customer. This process also documents the challenges faced by the technician during implementation for collective reference and process refinement.

Pre-requisites: Before building the product implementation orchestration, create Implementation team and Maintenance team, and associate users with these teams.

Creating an orchestration

  • Navigate to Settings and select Orchestration from the menu.

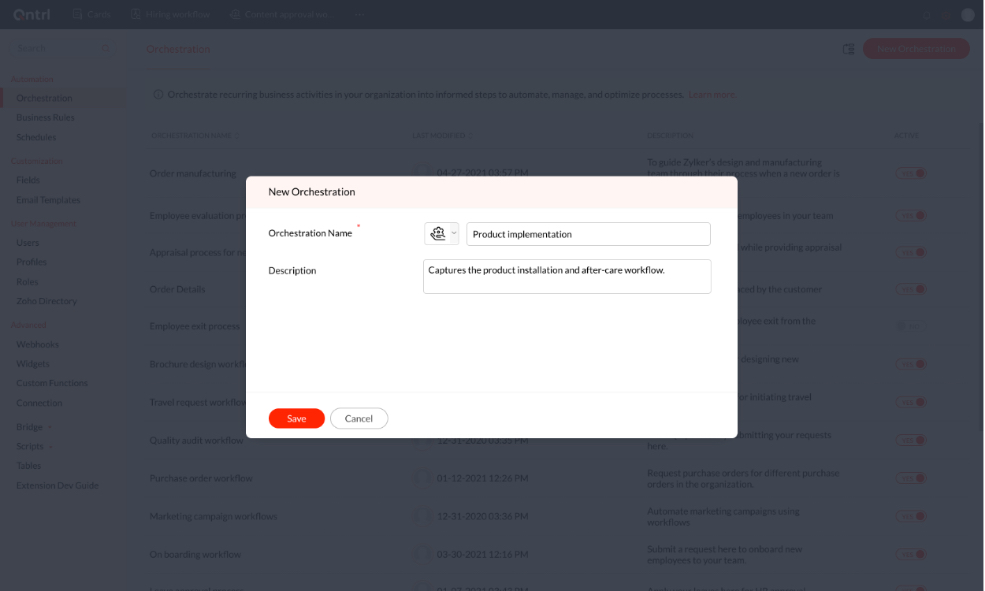

  • Click the New Orchestration button and fill in the name and description.

create-layout
  1 Step 1

  2 Step 2

  3 Step 3

  4 Step 4



Step 1:

The first step to initiate an orchestration is to create a form with relevant fields. Create 2 new sections-- 'Customer Details' and 'Implementation Details'-- and add the following custom fields to the form:

Field NameField TypeProperties
Company nameSingle-LineMandatory
Company sizeIntegerMandatory
IndustryDropdownOptions: Manufacturing, Export, IT Services, Others
Defect statusDropdownOptions: Open, Replaced, Closed Visibility: Off
Implementation challengesMulti-LineVisibility: Off

create-layout

Once the fields are added and the form is ready, click Save and Next.

Step 2
  1 Step 1

  2 Step 2

  3 Step 3

  4 Step 4



Step 2:

Blueprint helps to design the end-to-end processes of an organization. A single orchestration can host more than one blueprint for different criteria. The first blueprint of the orchestration must be created without any criteria but all other blueprints can be configured with suitable criteria.

Add the following stage names in the pop-up and then click Add to Blueprint.

  • Start implementation

  • Dependencies resolved

  • Execution underway

  • Setup complete

  • Demo complete

  • Feedback form sent

  • Challenges reported

  • Implementation complete (Closed stage)

create-layout

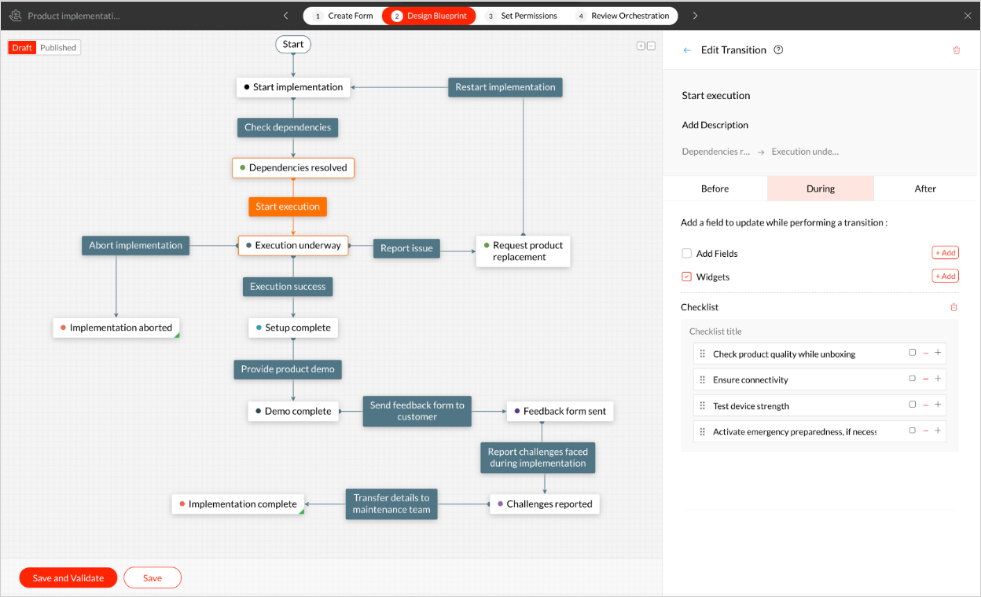

On adding the stages, a flowchart with pre-populated transition names is created.

Stages can also be added from the right panel of the blueprint editor. To add a new stage to this blueprint from the right panel,

  • Type the stage name in the search bar and click Add.

  • Now, drag and drop the stage into the blueprint editor on the left.

Here, let's add the stages 'Request product replacement' and 'Implementation aborted (Closed stage)' from the right panel.

You can also modify the transition names to suit your workflow. Here's a list of the transitions used:

  • Check dependencies

  • Start execution

  • Report issue

  • Restart implementation

  • Abort implementation

  • Execution success

  • Provide product demo

  • Send feedback form to customer

  • Report challenges faced during implementation

  • Transfer details to maintenance team

create-layout

Here, let us set the blueprint criteria as 'Company Size < 100'. If your blueprint does not allow you to set criteria, first create a blueprint without any criteria and try again. As the criteria is set for company size < 100, only cards meeting this condition will be mapped to this blueprint. This criteria can be customized or removed according to the requirement.

Now that the outline of the blueprint is done, we can get into the details like setting SLAs and transition conditions.

  • Click on the stage name to configure the stage deadline, early reminder, day-of reminder, and escalation alert.

  • Click on the transition name to configure conditions before, during, and after the transition occurs.

Stages:

Request product replacementStage DeadlineSend early reminderSend day-of reminderSend escalation alert


15 days

Set time: 3 days

Notify to: Assignee

Notify to: Assignee, assignee’s line manager

Set time: 1 day

Notify to: Team

create-layout

Transitions:

Check dependenciesBeforeDuringAfter


Who can perform this transition? Assignee

Which Cards can pass through this transition? All Cards

None

None

Start executionBeforeDuringAfter


Who can perform this transition? Assignee

Which Cards can pass through this transition? All Cards

Widgets: Checklist

None

create-layout

Report issueBeforeDuringAfter


Who can perform this transition? Assignee

Which Cards can pass through this transition? All Cards

Add New Multi_Line Field: Issue description

Update Fields: Defect status = Open

Restart implementationBeforeDuringAfter


Who can perform this transition? Assignee

Which Cards can pass through this transition? All Cards

None

Update Fields: Defect status = Replaced

Execution successBeforeDuringAfter


Who can perform this transition? Assignee

Which Cards can pass through this transition? All Cards

None

Send Email: Send execution report to the team involved

(Add an email template for execution report and configure an email alert to be sent to the Team.)

create-layout

create-layout

Provide product demoBeforeDuringAfter


Who can perform this transition? Assignee

Which Cards can pass through this transition? All Cards

None

None

Send feedback form to customerBeforeDuringAfter


Who can perform this transition? Assignee

Which Cards can pass through this transition? All Cards

None

Send email: Send implementation feedback form to customer

(Add an email template of the implementation feedback form and configure an email alert to be sent to the customer.)

Learn how to send emails to external email addresses.

create-layout

create-layout

Report challenges faced during implementationBeforeDuringAfter


Who can perform this transition? Assignee

Which Cards can pass through this transition? All Cards

Add Fields: Implementation challenges

None

Transfer details to maintenance teamBeforeDuringAfter


Who can perform this transition? Assignee

Which Cards can pass through this transition? All Cards

None

Associate custom functions: Custom function to create new card in Maintenance team's blueprint to follow up with monthly maintenance

(Use Create_Job custom function from the Function Gallery)

create-layout

Abort implementationBeforeDuringAfter

(Common transition for the stages: Start implementation, Dependencies resolved, Execution underway, Setup complete, and Request product replacement)

Who can perform this transition? Assignee

Which Cards can pass through this transition? All Cards

Add New Multi-Line Field: Reason for aborting implementation

Send email: Send an email about the aborted implementation to the customer.

(Add an email template for implementation abort and configure an email alert to be sent to the customer.)

Learn how to send emails to external email addresses.

create-layout

create-layout

Step 1Step 3
  1 Step 1

  2 Step 2

  3 Step 3

  4 Step 4



Step 3:

This step can be used to decide access for your employees. Depending on the confidentiality of the process, you can allow or restrict access.

Create Cards: Users mentioned here will be able to create Cards in this orchestration. Here, all the users in the organization can create cards.

Access Cards: Users mentioned here will have an end-to-end view of all Cards created using the Orchestration. Here, users from the Implementation team can access the cards.

create-layout

Step 2 Step 4
  1 Step 1

  2 Step 2

  3 Step 3

  4 Step 4



Step 4:

Once all the configurations are done, we can publish the orchestration and test its functioning by creating a card.

  • Click on the New Card button.

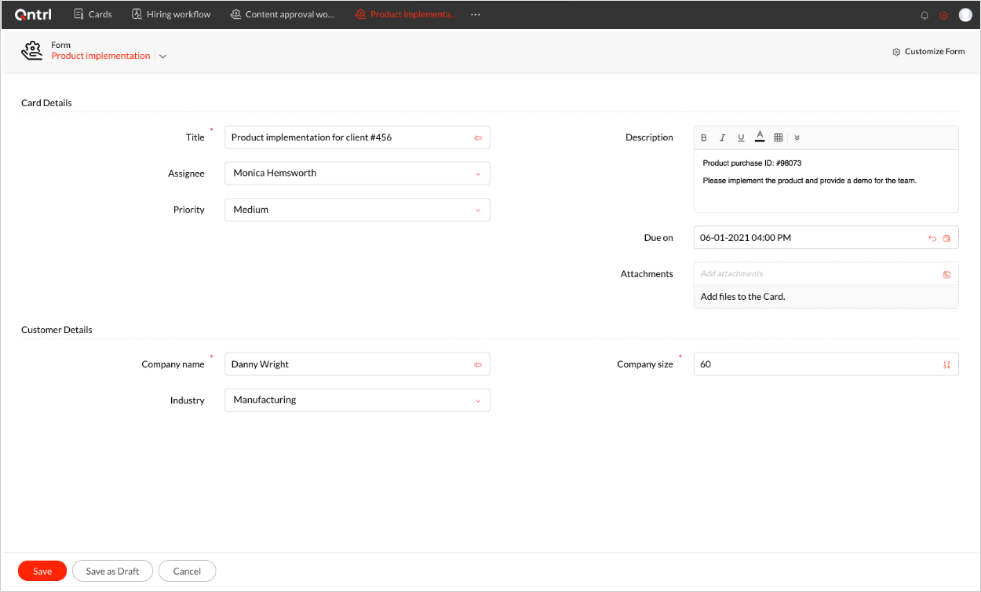

  • Fill in the details.
  • Click Save.
create-layout

Since the blueprint is created with the criteria Company Size < 100, only the cards meeting this condition will be routed through the Product Implementation Orchestration.

Once the card is created, it lands in the first stage: Start implementation. The user will be able to perform two transitions from this stage: Check dependencies and Abort implementation.

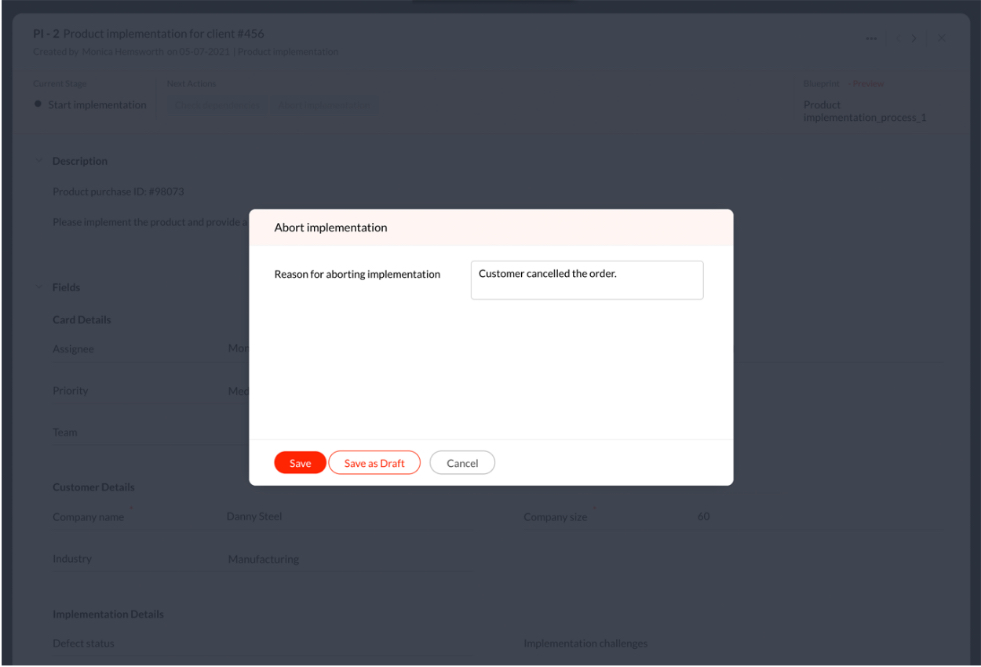

Abort implementation is a common transition and can be performed from any of the following stages: Start implementation, Dependencies resolved, Execution underway, Setup complete, and Request product replacement. While performing this transition, the user is prompted to fill the Reasons for aborting the implementation field. After the card is aborted, an email is sent to the customer.

create-layout

If the card is not aborted, the technician can continue installing the product.

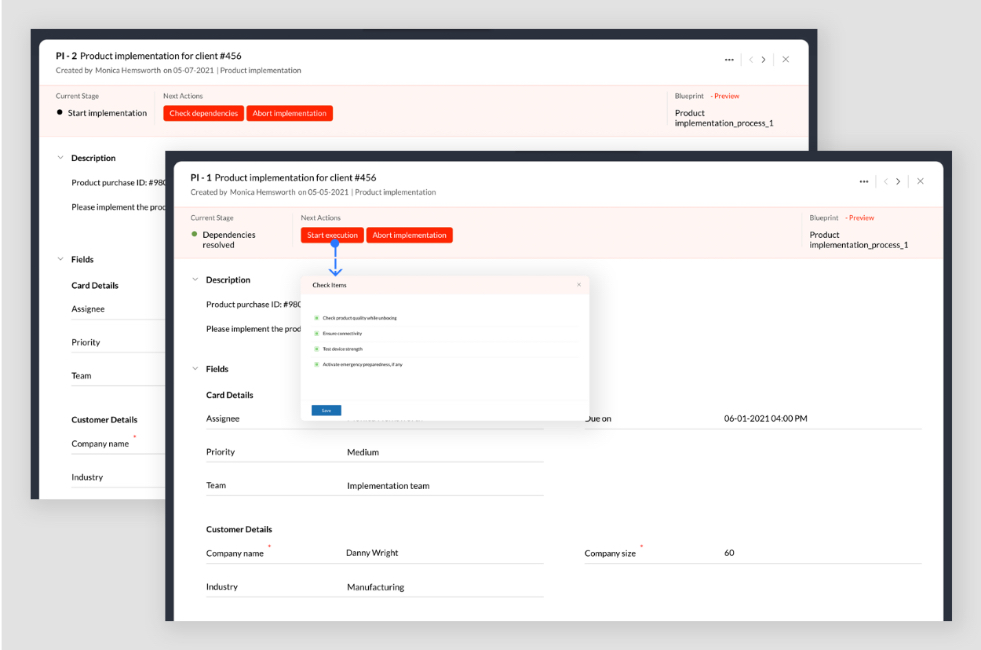

First, the technician checks external dependencies by clicking Check dependencies. If there are no dependencies involved or after the available dependencies are resolved, the technician clicks Start execution. A checklist pop-up will appear. The technician can check the items that are completed and then click Save.

create-layout

When the execution is underway, the technician can either declare Execution success or Report an issue.

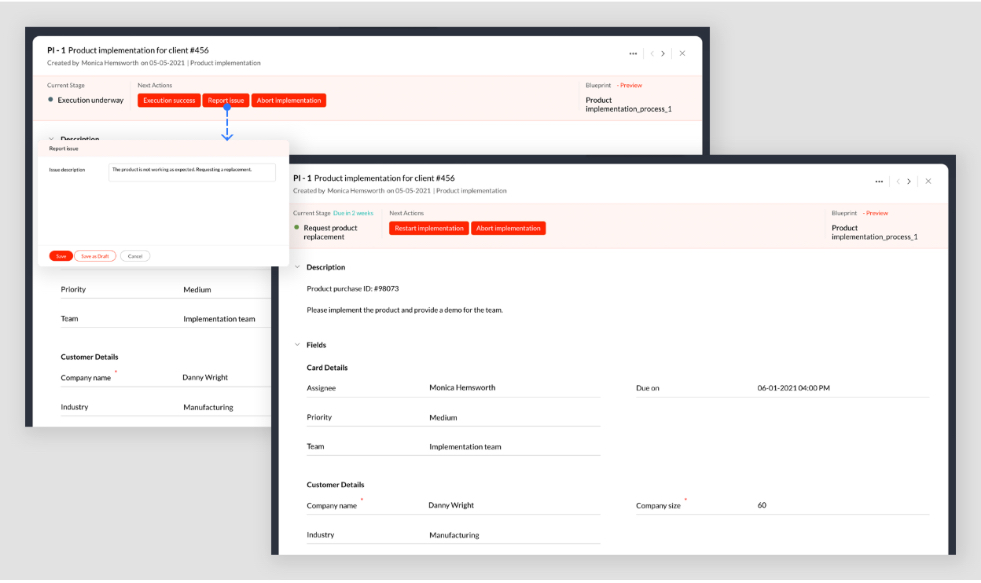

While reporting an issue, they will be prompted to fill the Issue description field. After the transition, the Defect status field is updated to Open.

Once the issue is filed, the card moves to Request Product Replacement stage. Since we applied SLA to this stage, the card can only stay here for 15 days.

  • On the 3rd day, an early reminder email is sent to the assignee.

  • On the 15th day, a reminder is sent to the assignee and their line manager.

  • On the 16th day, an escalation email is sent to the team manager.

Once the product is replaced, the technician goes back to implementing the product again by clicking Restart implementation. Now, the Defect status field is updated to Replaced.

create-layout

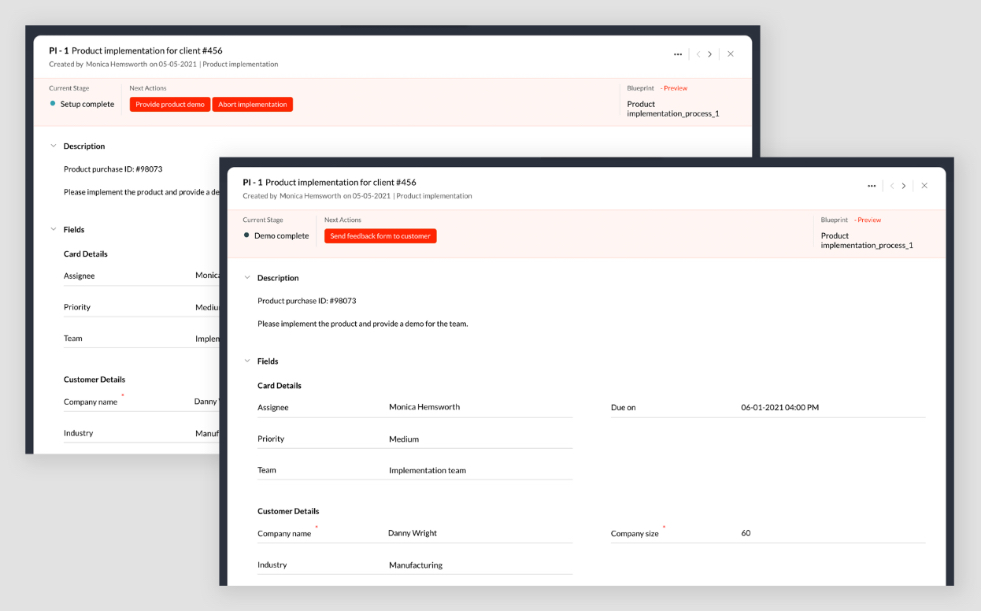

If the execution succeeds, the technician proceeds with the product demo by clicking Provide product demo. Once the demo is complete, the technician clicks Send feedback form to customer which triggers a feedback email to the customer.

create-layout

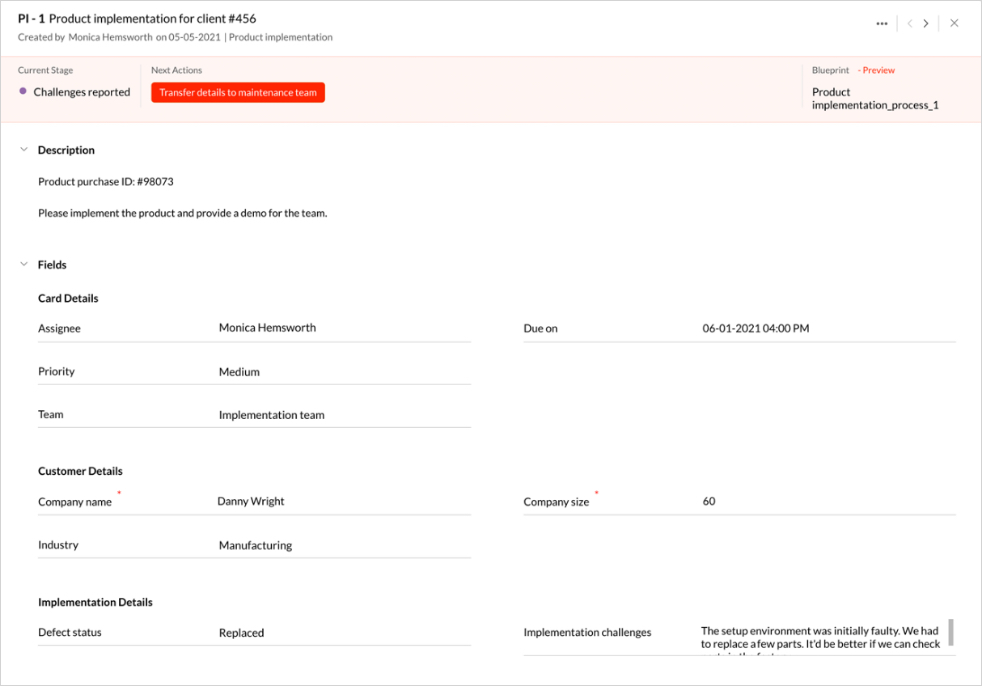

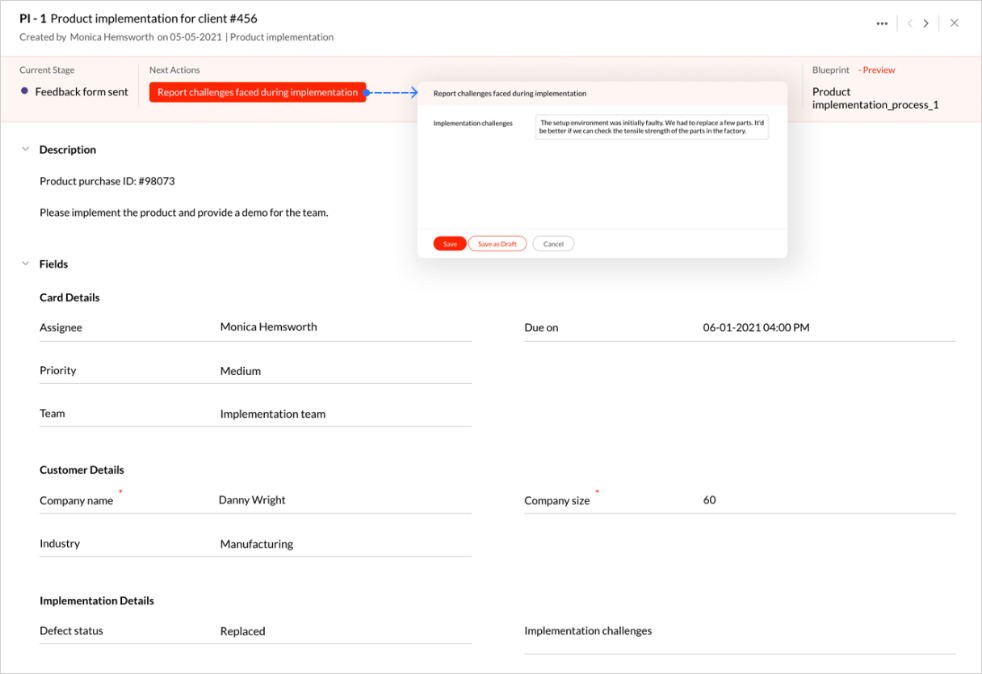

Once the implementation steps are complete, the technician can record any implementation challenges by clicking Report challenges faced during implementation. This helps the team fine tune the process and resolve issues before future installations.

create-layout

After the implementation team's work is done, the maintenance team can follow up with periodic maintenance and support. To transfer responsibility for the card, the technician performs the Transfer details to maintenance team transition. After this transition is performed, a custom function is triggered to create a new card under the maintenance team's blueprint briefing the customer details.

create-layout

Finally, the card moves to the Implementation complete stage.

The end-to-end actions performed in the card can be viewed under the Activities section.

create-layout

We have successfully configured and executed the Product implementation Orchestration. Let's explore the next scenario.
